How much of Ras Malé has been built?

Ras Malé is being reclaimed from Fushidhiggaru lagoon in twelve sites. Here is every published figure, site by site, with its date and source. When a site has no published figure, we say so.

Overall progress

About 70%

reclaimed · last hectare figure ~500 of 1,009 ha (31 Mar 2026)

Notify me when it changes

500 ha

reclaimed by 31 Mar 2026

1,009 ha

total to reclaim

11 of 12

sites with active work

65,000

housing units planned

Last official update: 26 September 2026 · President Mohamed Muizzu on PSM's Nation Chat, via Atoll Times

Planned total from the President's Office. Some sites publish other totals, such as 1,150 ha.

The twelve sites

Colours show each site's status. Sites reported together share one figure.

Completed In progress Awaiting update
ABCDEFGHIJKL
Schematic layout, not to scale. Tap a site for its details.

Site by site

Reclamation sites, planned area, contractor, latest published figure and status
SitePlanned areaContractorLatest figureStatus
J29 haCMC (Sri Lanka)Fully reclaimed, Nov 2025Completed
A137.5 haMACL with Jan De Nul116 ha (84%), 12 Feb 2026In progress
D, F, G, L395 ha combinedMohan Mutha Exports, CRCC100.6 ha, Aug 2025; Site L 25.53%, Nov 2025In progress
C190 haChina Harbour (CHEC)20.09%, Nov 2025In progress
E75 haChina Harbour (CHEC)No site figure publishedAwaiting update
B, H, I183.5 ha combinedNot reportedNo site figure publishedAwaiting update
KNot publishedNot reportedNo site figure publishedAwaiting update

Timeline

  1. Sep 2026

    About 70% reclaimed, with completion targeted for the end of 2026

    Source: Ras Malé project will proceed, no foreign land ownership: President (Atoll Times)
  2. 21 Sep 2026

    Commercial terms signed with Eagle Hills for a waterfront on about 500 ha

    Source: Eagle Hills signs $12 billion Maldives waterfront deal (Gulf News)
  3. Jun 2026

    Work slows as fuel costs rise; about 60% reclaimed

    Source: Rasmalé land reclamation faces temporary slowdown (Dredging Today)
  4. Jun 2026

    Housing for All closes with 58,505 applications

    Source: Over 58,000 applications for government housing schemes (Adhadhu)
  5. 31 Mar 2026

    Nearly 500 ha reclaimed across 11 sites

    Source: Housing for All initiative: Rasmalé project reclaims nearly 500 hectares of land (Dredging Today)
  6. Feb 2026

    Site A at 84%

    Source: Rasmalé Site A reclamation reaches 84% completion (MMTV)
  7. Jan 2026

    Housing for All applications open: 15,000 plots and 7,900 flats

    Source: Application opened for 'Housing for All' policy (Maldives Financial Review)
  8. Dec 2025

    Transport master plan put out to tender

    Source: Rasmale' Transport Master Plan: request for expressions of interest (Government Gazette)
  9. 1 Dec 2025

    Site A begins with the Cristóbal Colón

    Source: Rasmale' land reclamation reaches 30% completion, MACL says (MV+)
  10. Nov 2025

    Site J completed

    Source: President inspects progress of Rasmalé Land Reclamation Project (President's Office)
  11. Oct 2025

    City master plan put out to tender

    Source: Consultancy Services for the Preparation of Rasmale' Master Plan (Government Gazette)
  12. 2 Aug 2025

    China Harbour agreement signed for Sites C and E (265 ha)

    Source: Rasmalé reclamation work starts with Chinese company on site (MMTV)
  13. Apr 2025

    101 ha reclaimed, about 10% of the planned land

    Source: RasMale': 10 percent now reclaimed (The Edition)
  14. 10 Nov 2024

    Reclamation resumes after a six-month pause

    Source: Land reclamation resumes at Rasmalé (Dredging Today)
  15. Jun 2024

    Government decides to end the first contractor's (CMC's) contract after 29 ha

    Source: Rasmale' reclamation deal with CMCC to be terminated (Adhadhu)
  16. 18 Dec 2023

    Reclamation of Fushidhiggaru lagoon launched

    Source: President Dr Muizzu declares that Ras Malé will develop as a zero-carbon, safe island (President's Office)

Latest progress news

More progress news →
The Housing Development Corporation's office building, with the HDC sign above the entrance and palm trees in front

Progress · Oct 2026

Who Pays for Ras Malé? The Cost of Building the Land

Nobody has published a full bill for Ras Malé. But the pieces are on the record: a contractor-financed plan that failed, a budget line Parliament removed, a loan through HDC whose size is secret, and a waterfront deal the government says will pay much of it back.

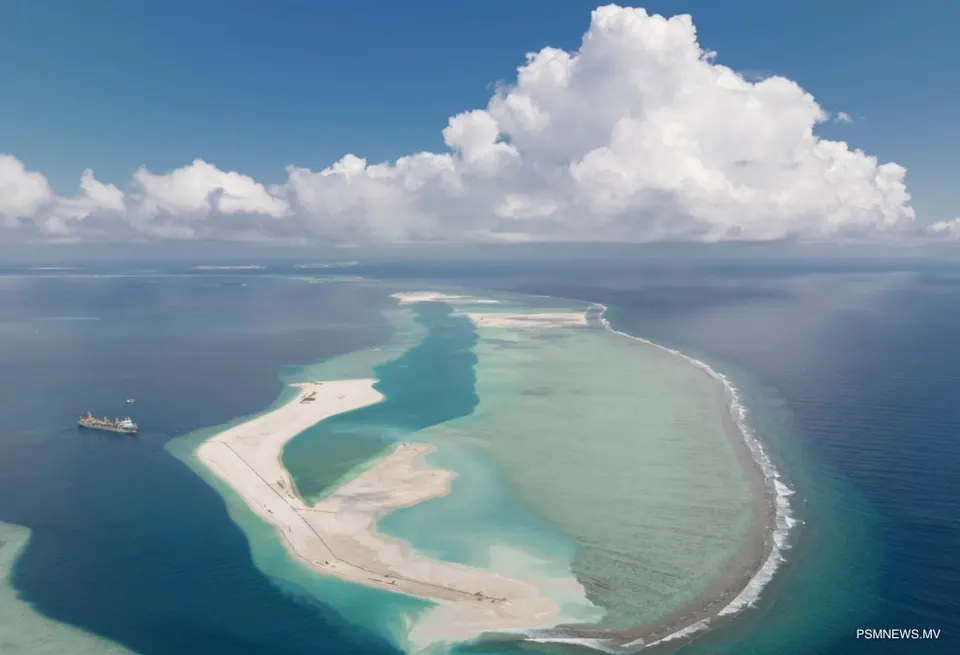

Aerial view of a new reclaimed island at Ras Malé with a base camp and jetty, surrounded by shallow reef and turquoise lagoon

Progress · Oct 2026

Ras Malé's Environmental Impact: Sediment, Reefs and Bait Fishing

Reclaiming a thousand hectares of lagoon changes the sea around it. Here is what has been reported about Ras Malé's effects on reefs, water quality and fishing, what's been done to limit them, and why the government calls it a climate adaptation project.

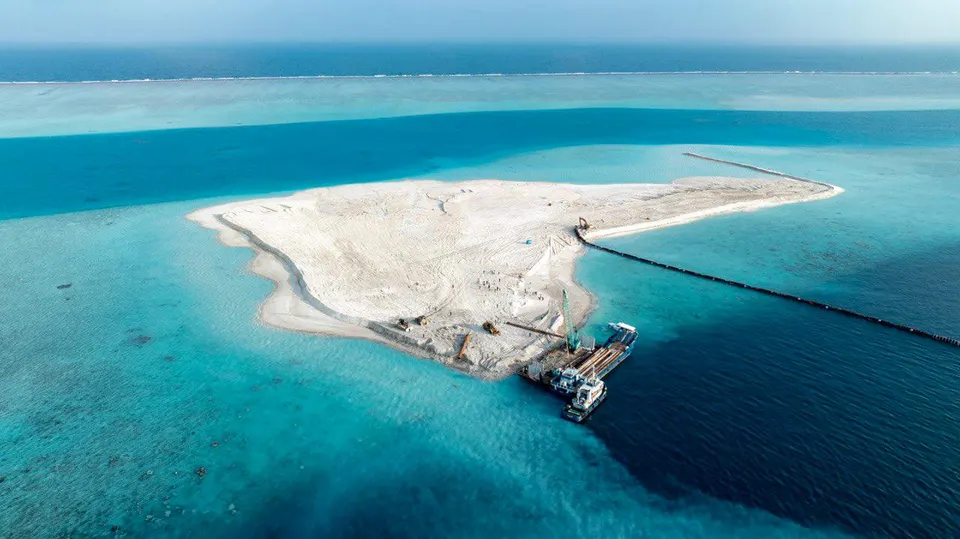

Aerial view of a contractor's base camp on reclaimed sand at Ras Malé, with site offices, containers and rows of construction machinery

Progress · Oct 2026

CMC, CRCC, CHEC and MACL: Who Has Built Ras Malé So Far

Five companies have been hired to reclaim Ras Malé in under three years, and two of them left with the work unfinished. Here is who each contractor is, which sites it took on, what it delivered and what it cost.

Sources

Where the figures on this page come from. The source always takes priority over this site.

Get an alert when the numbers change

One email when a new official figure is published, at most once a day. Unsubscribe any time.

The Ras Malé update, once a month

Progress numbers, new guides and places that open. No spam.
